Let’s be honest, project financial management is way more than just counting beans after the fact. It’s the strategic system you put in place to plan, track, and control a project's money from kickoff to closeout. Done right, it ensures you actually finish on budget.
Think of it like the GPS and fuel gauge for your project. Without it, you’re basically driving blind and just hoping you have enough gas to make it to your destination. It's not about looking in the rearview mirror at money already spent; it's an active, forward-looking discipline that guides you from the initial idea all the way to the final deliverable.
Let's break it down with a simple analogy: you're the captain of a ship on a long voyage.
This proactive approach is what separates the projects that succeed from the ones that sink under financial pressure. It’s not about blame; it’s about having control. By actively managing these pieces, you can steer your project to its destination efficiently and deliver the value you promised.
You can see this strategic thinking reflected in the market. The global project portfolio management market was valued at $6.13 billion in 2024 and is on a serious growth trajectory. Why? Because organizations get it. In fact, around 80% of project managers see it as essential for connecting projects to real business goals. If you want more stats, you can discover more insights about project portfolio management here.
"Managing project finances is less about crunching numbers and more about telling the future. It’s the art of using today's data to make smarter decisions for tomorrow, turning potential financial disasters into predictable successes."
Throughout this guide, we'll dig into the core pillars that make this happen. We’re talking resilient budgeting, predictive forecasting, and powerful performance tracking. By the end, you'll have a clear map to confidently navigate the financial waters of any project you take on.

A project budget is so much more than a spreadsheet filled with numbers. Think of it as the financial blueprint for success. Building one that can actually stand up to real-world chaos—like a key supplier suddenly doubling their prices or an unexpected delay—is a fundamental skill in project financials management.
A solid, resilient budget acts as a financial shock absorber. It gives your project the stability it needs to not just survive the unexpected, but to push through and cross the finish line.
But getting there requires moving past simple guesswork. To build a budget that holds up, you need to master project cost estimating and keep a tight grip on budget control. Let’s walk through three proven methods for creating a financial plan you can count on.
Every project is different, so it makes sense that your estimation method should be, too. The right technique really boils down to how much detail you have to work with from the get-go.
Analogous Estimating: This is your go-to when you're flying blind with very few details. You simply look at similar projects you've done in the past and use their final costs as a rough guide. For example, if a previous software feature cost $50,000 to build, you might pencil in a similar amount for a new, comparable one. It's fast, but not the most precise.
Parametric Estimating: This method brings a bit more science into the mix by using a specific unit cost. You just multiply the cost per unit by the total number of units you need. If you know each user interview costs $250 and you plan on doing 20 of them, you can confidently budget $5,000 ($250 x 20) for that specific task.
Bottom-Up Estimating: This is the gold standard for accuracy. You break the entire project down into its smallest, most granular tasks, figure out the cost for each tiny piece, and then add it all up. It's a lot of work upfront and requires a crystal-clear project scope, but it gives you a highly detailed and defensible final number.
By picking the right estimation method for your situation, you shift your budget from a hopeful guess to a calculated plan. That precision is the very first step toward having real financial control over your project.
Let's be honest: no project ever goes exactly as planned. That's precisely why a resilient budget has financial cushions built right in to handle different kinds of risks.
There are two main types of reserves, and they serve completely different purposes. Mixing them up is a common mistake that can leave you scrambling when things go sideways.
1. Contingency Reserves These funds are set aside for the "known unknowns"—risks you can identify ahead of time but can't predict with 100% certainty. Think of things like a key developer getting sick for a week or a software license renewal coming in higher than quoted. This reserve is part of your main budget (the cost baseline) and is managed by the project manager.
2. Management Reserves This is a separate pot of money for the "unknown unknowns"—those major, out-of-the-blue events that are way outside the project's original scope. This could be a sudden market crash that forces a change in project requirements or a major corporate restructuring. This money is not part of the project's cost baseline, and tapping into it requires a sign-off from senior management.
Once you’ve nailed down your estimates and added in your contingency reserves, you've got your cost baseline. This is the official, approved budget that your project’s performance will be measured against from this point forward.
It isn’t just a single lump sum. It's a time-phased plan that shows how much you expect to spend over the project's entire timeline.
This baseline becomes the yardstick for all future spending. Any deviation from it is a "variance" that you'll need to track, analyze, and explain. This benchmark is the cornerstone of effective project financials management, giving you a solid, defensible plan to monitor and control your costs from day one to project close.

If your budget is the roadmap you planned before the trip, then financial forecasting is your live GPS. It’s the active, ongoing process of looking ahead, using real-time data to predict your project's financial future. This is where great project financials management shifts from simply planning to actively steering the ship.
A budget is a static document, a snapshot in time approved before any work begins. Forecasting is completely different; it's a dynamic prediction. It constantly updates your estimated arrival time and cost, warning you about upcoming traffic jams (cost overruns) or clear roads ahead (potential savings) long before you hit them.
This ability to see what's coming is what separates proactive project managers from reactive ones. It's the difference between telling your boss you're already over budget versus showing them you have a plan to avoid it altogether.
You don't need a crystal ball to forecast accurately. You just need a couple of key metrics that tell you exactly where your project is heading. Two of the most important are the Estimate to Complete (ETC) and the Estimate at Completion (EAC). Let's break them down without the confusing textbook jargon.
Estimate to Complete (ETC): This simply answers the question, "How much more money do we need to finish what's left?" It's a forward-looking guess on all future costs from this moment until the project is done.
Estimate at Completion (EAC): This tackles the big-picture question: "Based on how things are going, what's the new total cost for the whole project?" It takes what you've already spent and adds the ETC to give you a revised final number.
These two metrics work together to give you a brutally honest look at your project's financial reality.
Let's walk through a real-world scenario. Imagine you're running a $100,000 marketing campaign. You've just hit the halfway mark (50% complete), but a quick look at the books shows you've already burned through $70,000.
Your gut is probably screaming that something's wrong, but forecasting gives you the hard data to prove it and start finding a solution. Your Actual Cost (AC) is $70,000, and your original Budget at Completion (BAC) was $100,000.
Forecasting isn't about blaming the past; it's about correcting the future. By regularly calculating your EAC, you gain the clarity needed to make tough decisions early, when they can still make a difference.
To figure out your new projected total cost (the EAC), you have to look at your spending efficiency so far. You've completed $50,000 worth of work but spent $70,000 to do it—not a great ratio. If that trend continues, the remaining $50,000 of work is also going to cost more than planned. A simple EAC calculation would project a new total cost of $140,000, putting you on track for a $40,000 overrun.
This is the real power of forecasting. Instead of finding out about that $40,000 shortfall when the project is over, you see it coming with half the work still to go. Now you have time to actually do something about it.
With this forecast in hand, you're back in control. Maybe you need to scale back the campaign's scope. Perhaps you can find more cost-effective vendors. Or maybe you need to go back to stakeholders and ask for more funding, but this time you have a data-backed case to present. For a deeper dive on anticipating your financial position, this guide on cash flow projection is a great resource.
Regular, honest forecasting builds incredible trust with stakeholders. It proves you have a firm grip on the project's financial reality and are managing their investment responsibly. By seeing around the corners, you can navigate challenges with confidence and keep your project financially healthy from start to finish.
So, you’ve got your budget and your forecast. Great start. But how do you know if you're actually hitting those targets while the project is in full swing? Relying on gut feelings or a simple "we're about 50% done" is a recipe for disaster. This is where a surprisingly powerful technique in project financials management called Earned Value Management (EVM) comes into play.
EVM gives you a clear, unified way to answer two massive questions at any point in your project: "Are we getting the value we paid for?" and "Are we on schedule?" It stops you from just comparing what you planned to spend versus what you actually spent. Instead, it pulls in the scope of work completed, giving you a brutally honest look at your project's health.
To get your head around EVM, you first need to understand its three core ingredients. Think of these as the fundamental data points that fuel every insight. Let's walk through an example: imagine you're building a new website feature with a total budget of $10,000, slated to take 100 hours of work.
Planned Value (PV): This is the budgeted cost for the work you planned to have finished by a certain date. It’s your baseline. So, after 50 hours (halfway through the project), your PV should be $5,000. Simple enough.
Earned Value (EV): Here's where it gets interesting. This is the budgeted cost of the work you've actually completed. If, after those same 50 hours, your team has only knocked out 40% of the total work, your EV is $4,000 (which is 40% of the $10,000 total budget). This is the true value you've "earned" so far, regardless of how much time or money you've spent.
Actual Cost (AC): This one is straightforward—it’s the cold, hard cash you've actually spent to date. Let's say your books show you've shelled out $6,000 so far.
With these three metrics in hand, you can stop basic tracking and start doing some powerful analysis.

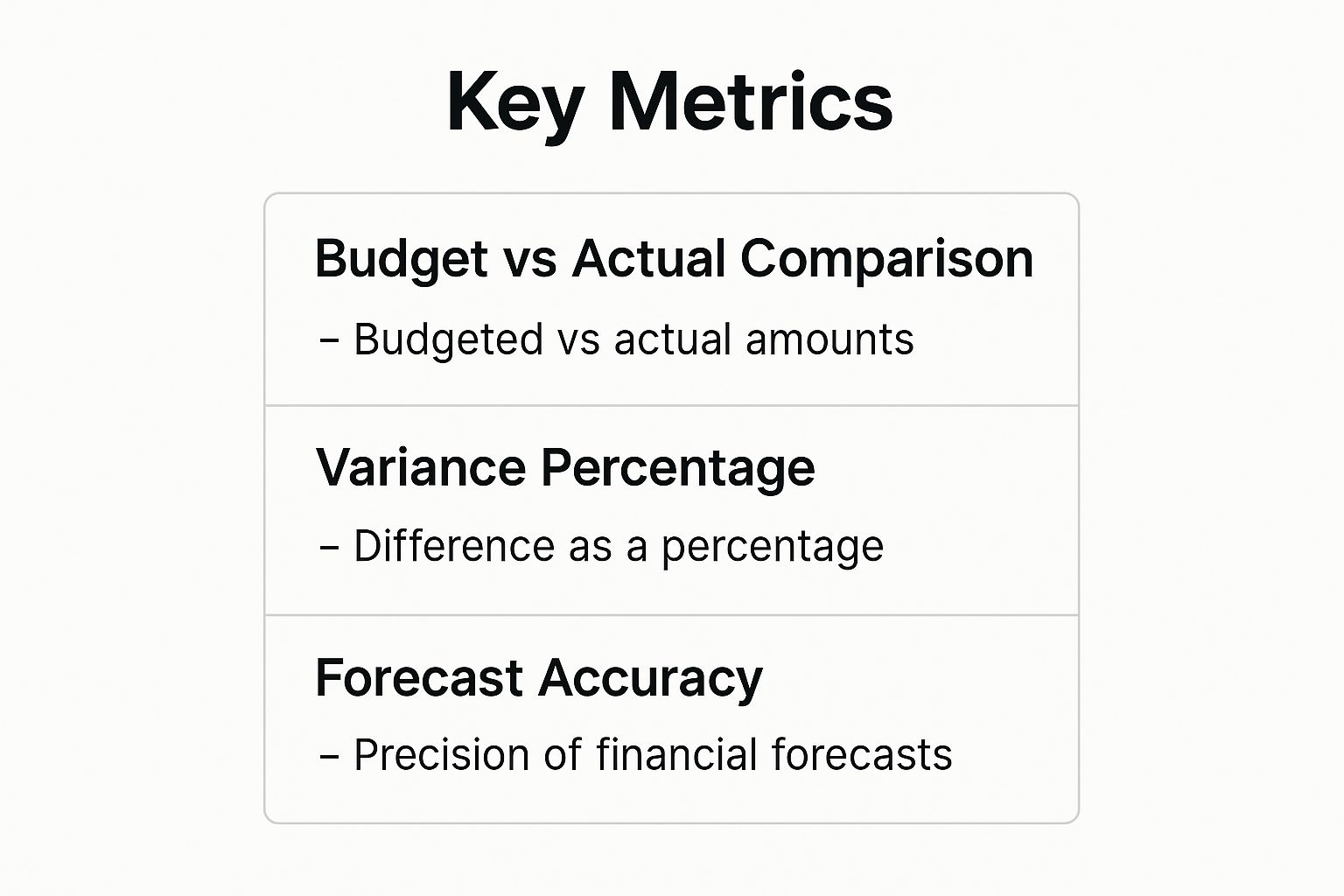

As the infographic shows, the moment your actual costs creep over your budget, you’re in the red. This isn't just a number; it's a signal flare telling you it's time to take action.
Now for the fun part. We can use those three pillars to calculate a couple of vital performance indexes. These act like a real-time health score for your project, instantly telling you whether you're winning or losing. A score above 1.0 is good. Below 1.0? You've got a problem.
This is your go-to metric for financial efficiency. It directly answers the question: "For every dollar we're spending, how much value are we actually getting back?"
CPI = Earned Value (EV) / Actual Cost (AC)
Using our example: CPI = $4,000 (EV) / $6,000 (AC) = 0.67. A CPI of 0.67 is a massive red flag. It means that for every single dollar you've burned, you've only earned 67 cents worth of the project you planned. You are bleeding money.
This index tells you how you're tracking against time. Are you ahead of schedule, or are you falling behind?
SPI = Earned Value (EV) / Planned Value (PV)
Again, with our example: SPI = $4,000 (EV) / $5,000 (PV) = 0.80. An SPI of 0.80 confirms you're behind schedule. You've only completed 80% of the work you were supposed to have finished by now.
The table below breaks down these core EVM metrics and a few others into a quick-reference guide.
| Metric | Formula | What It Tells You (>1 is good, <1 is bad) |
|---|---|---|
| Cost Performance Index (CPI) | EV / AC | Are you over or under budget? A CPI of 0.8 means you get $0.80 of value for every $1 spent. |
| Schedule Performance Index (SPI) | EV / PV | Are you ahead of or behind schedule? An SPI of 0.9 means you're progressing at 90% of the planned rate. |
| Cost Variance (CV) | EV - AC | The direct dollar amount you are over or under budget. Negative is bad. |
| Schedule Variance (SV) | EV - PV | The value of work you are ahead or behind schedule, expressed in dollars. Negative is bad. |
These simple formulas turn raw data into a clear story about your project's performance, leaving no room for guesswork.
Without EVM, you might look at the $6,000 spent and think, "Well, we're 60% through the budget, maybe we're 60% done. Not too bad." But EVM paints the real picture: you've burned through 60% of the budget to complete only 40% of the work. That's a completely different—and much more alarming—story.
This kind of data-driven clarity is non-negotiable, especially when the economy gets shaky.
In fact, the global project finance market saw values dip by 10.87% to $348.79 billion in the first half of 2025 due to economic headwinds. In an environment like that, the margin for error on project budgets gets razor-thin. You can read the full infrastructure finance report and its findings here.
By tracking EVM metrics consistently, you swap ambiguity for objective facts. It gives you the power to spot a project going off the rails early, make smart course corrections, and explain the project's true status to stakeholders with total confidence.
The right tech stack can turn project financial management from a painful, reactive chore into a serious strategic advantage. Let's be honest, manual spreadsheets and clunky, outdated processes are breeding grounds for human error and give you almost zero real-time visibility. Modern tools, on the other hand, deliver the clarity and automation you need to make smarter, data-driven decisions that actually move the needle on your project's bottom line.
Picking the right platform is a bit like choosing a vehicle for a road trip. A bicycle is great for a spin around the block, but you wouldn't take it cross-country. In the same way, the tool you need depends entirely on the scale and complexity of your project.
For small, straightforward projects with just a few moving parts, a well-organized spreadsheet can be surprisingly effective. Tools like Microsoft Excel or Google Sheets are accessible, familiar to everyone, and don't require you to spend a dime.
They're a solid choice for:
But be warned: spreadsheets hit their limits fast. As projects get bigger, they quickly become a liability. They can't integrate data in real-time, it's a nightmare for multiple people to update them at once, and they are notoriously prone to tiny formula errors that can throw your entire financial picture off course.
When you need more firepower and better collaboration, dedicated project management platforms are the next logical step up. Tools like Asana, Trello, and Monday.com don't just track tasks; they bake financial tracking right into your project workflows, creating a single source of truth for the whole team.
For example, a platform like Monday.com can give you a clean, visual dashboard for keeping an eye on financials. This kind of interface brings your project tasks, timelines, and budgets together in one place, giving everyone on the team instant visibility into the project's financial health. These platforms are brilliant at connecting the work being done with the money being spent.
The best platforms don't just track numbers; they provide context. By linking budgets to specific tasks and milestones, you can immediately see the financial impact of your team's progress and make adjustments on the fly.
It's no surprise that the demand for these integrated solutions is exploding. The project management software market is on track to hit $7.24 billion by 2025 and is expected to climb to an incredible $12.02 billion by 2030. Despite this, only about 23% of organizations are actually using dedicated software, which points to a massive opportunity for a competitive edge. You can discover more insights about project management software trends here.
For large organizations juggling a whole portfolio of complex, interconnected projects, enterprise-level solutions are non-negotiable. These systems are the heavy machinery of project financials, built for robust management at scale and packed with sophisticated features that go way beyond basic tracking.
When you're looking at enterprise tools, you want to see things like:
These powerful systems are designed to tame the complexity of large-scale operations, ensuring you have tight financial control and governance across the entire organization. At the end of the day, picking the right tool—whether it's a simple spreadsheet or a full enterprise suite—is a critical decision that will directly support your project's success.

Even after you've got the basics down, the real world of project financials management is going to throw some curveballs. It’s one thing to know the theory, but it’s another to deal with the practical questions that pop up on the job.
Let's dive into a few of the most common sticking points I've seen over the years. Think of this as your quick-reference guide for navigating those tricky conversations and decisions with a bit more confidence. We’ll clarify some confusing terms, prep you for surprises, and highlight a few critical mistakes to sidestep.
So, what's the actual difference between project accounting and financial management? This one trips people up all the time, but it’s pretty simple when you boil it down: one looks backward, and the other looks forward.
Project accounting is like your car's rearview mirror. It’s all about meticulously recording what’s already happened—tracking every dollar spent with precision. Its job is to be the official scorekeeper, making sure the historical data is accurate and compliant.
Project financial management, on the other hand, is about looking through the windshield. It takes that historical data from accounting and uses it to budget, forecast, and steer the project where it needs to go. It’s the active, strategic part of the job.
"Accounting tells you what you spent. Financial management tells you what to do next. One is about reporting the past; the other is about shaping the future."
In short, accounting gives you the hard facts. Financial management puts those facts to work to make smarter decisions for the future.
What do you do when costs pop up that nobody saw coming? The best way to handle a surprise is to not be surprised at all. You need to build a financial safety net right into your budget from day one. This usually comes in two forms.
When an unexpected cost does hit, you don't just grab cash from these reserves. A formal change control process is crucial. This ensures that any withdrawal is properly approved and the budget baseline is officially updated, keeping everything transparent and preventing your budget from spiraling out of control.
Keeping track of all your project communications—especially the critical financial updates—can feel like a full-time job. With NotionSender, you can send and receive emails right from your Notion workspace, pulling all your project details into one central hub. It's a simple way to streamline your workflow and make sure nothing important gets lost in an overflowing inbox. Discover how NotionSender can organize your projects today.
